“SKID” SINTACLOR
® Installation: "All ready to start!" >
T

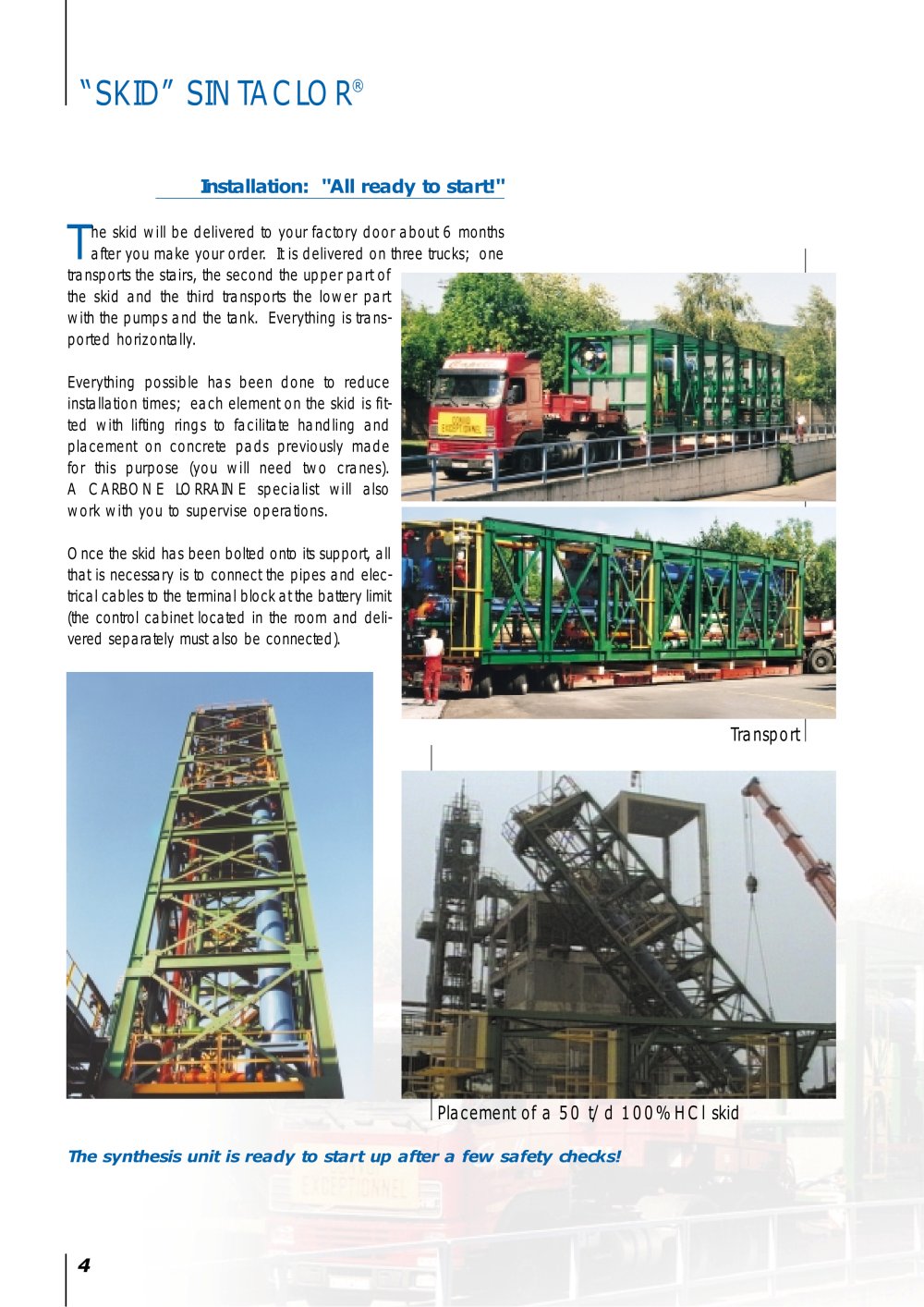

he skid will be delivered to your factory door about 6 monthsafter you make your order. It is delivered on three trucks; onetransports the stairs, the second the upper part of
the skid and the third transports the lower part
with the pumps and the tank. Everything is trans-
ported horizontally.Everything possible has been done to reduceinstallation times; each element on the skid is fit-ted with lifting rings to facilitate handling and
placement on concrete pads previously made
for this purpose (you will need two cranes).
A CARBONE LORRAINE specialist will also
work with you to supervise operations.Once the skid has been bolted onto its support, allthat is necessary is to connect the pipes and elec-
trical cables to the terminal block at the battery limit
(the control cabinet located in the room and deli-
vered separately must also be connected). The synthesis unit is ready to start up after a few safety checks! Transport Placement of a 50 t/d 100% HCl skid 4 >
